CURRENT & PROPOSED PROJECTS
2026 - Warrington Park Trail Paving
Estimated completion: October 2026
Warrington Park Trail will be transformed from limestone grading to pavement in order to improve accessibility for the public.
- Grading and Drainage Installed Monday
- Fine Grading Tuesday
- Concrete path along Lois Ln installed Wednesday
- Asphalt install Thursday
Trail will be paved and open Friday Oct 30
2026 - Sport Courts
Estimated completion: Fall 2026

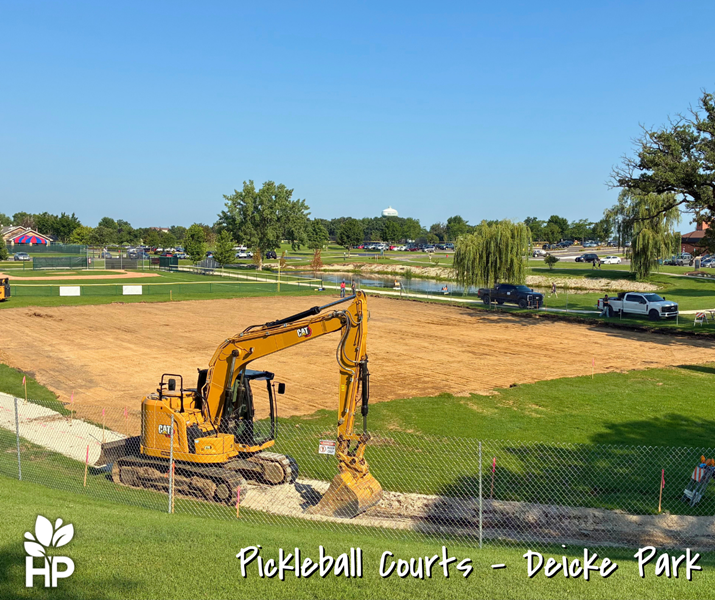

Deicke Park Pickleball Courts
Target Completion Date: September 21
-8 dedicated pickleball courts
-A drinking fountain to keep players hydrated
-Shade structures covering the non-playing areas for added comfort
-Bleacher seating for spectators and players waiting to jump into the next game

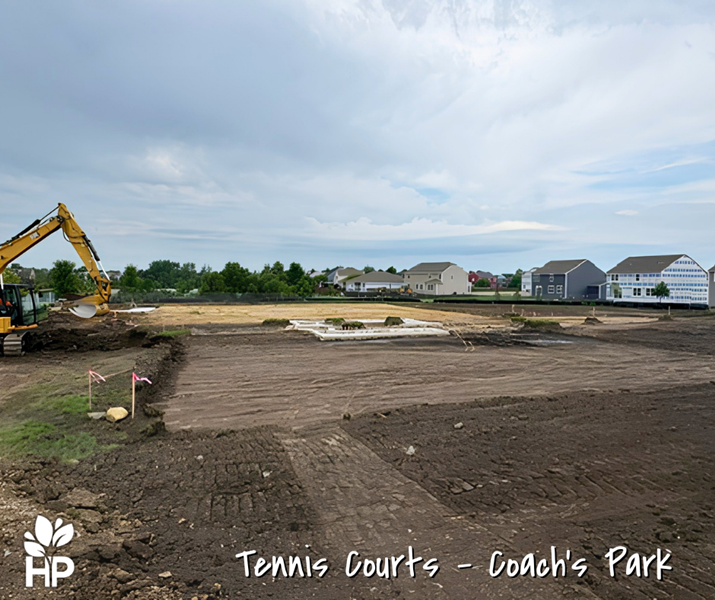

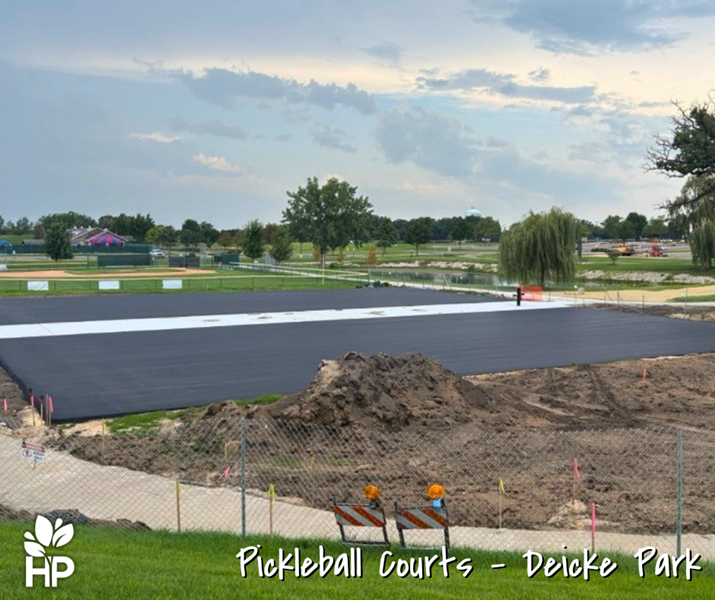

(8) Pickleball Courts will be added to Deicke Park & Tennis and Basketball Court added to Coach's Park
More updates to follow.
2026 - Golf Entertainment
Estimated completion: Winter 2026
Construction slated to take place between September 1 - December 1, 2026.
More updates to follow.
2026 - Additional Shade at Parks
Adding 60 trees to various park by September 2026.
2026 - Bridge Projects
Adding or replacing multiple bridge in Fall 2026.
- Add a bridge at Tomaso Sports Park;
- Replace the bridge on Hole #1 at Pinecrest; and
- Replace the wood decking on several structurally sound bridges on Pinecrest’s back nine.
2026 - Kreutzer Road Park
Breaking ground in Spring of 2027 - Phase 1 of OSLAD Grant.
RECENTLY COMPLETED PROJECTS

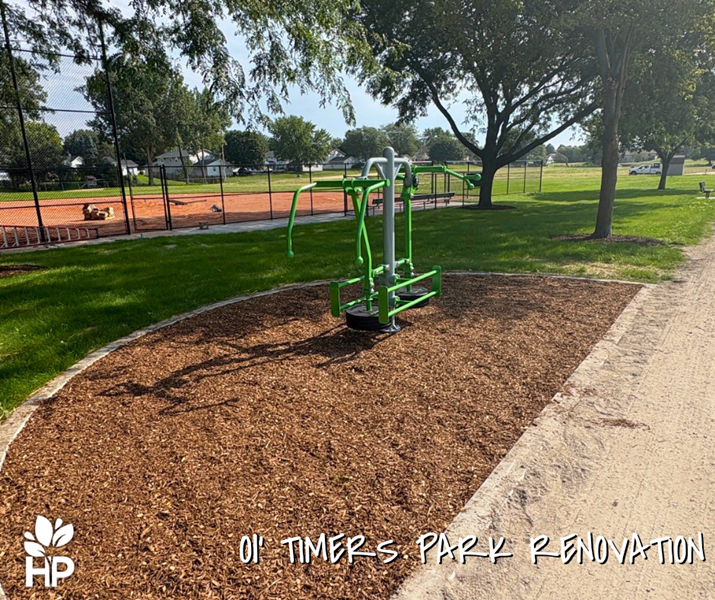

2026 - Ol' Timers Park Renovation
Project completed in September 2026.
After being awarded a $384,500 matching grant from the Open Space Land Acquisition and Development (OSLAD) program, the Huntley Park District will be facilitation the renovation of Ol' Timers Park, enhancing recreational opportunities for the community.
The renovation of Ol' Timers Park is a key component of the district's comprehensive plan to enhance and expand recreational facilities, ensuring they meet the evolving needs of the Huntley community. The project is slated to begin in late 2025, with completion anticipated in 2026.
Project outline:
-
The NEW wiffle ball field has been seeded and needs a few more weeks for the grass to become established. Please stay off the field until it is ready for play.
-

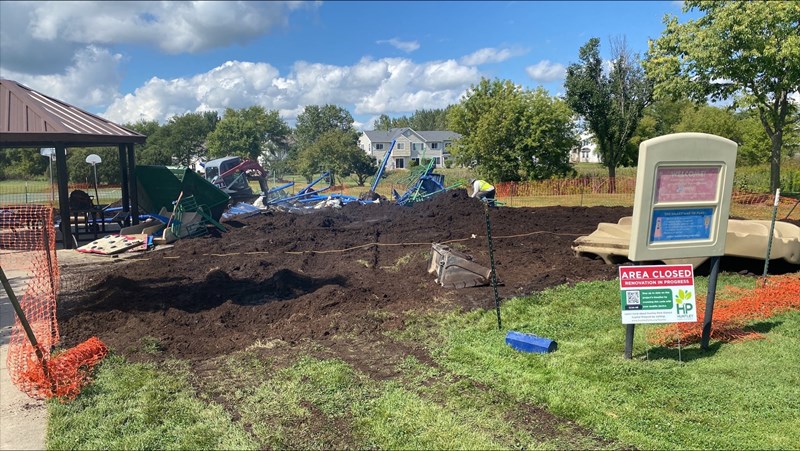

Ground restoration is continuing on the east side of the park near Timer Drive. Please be mindful of posted signs and any temporarily restricted areas.
-
The new prairie and wetland natural area southwest of the park is still a work in progress. Frequent rain over the past two months has delayed planting, so for now it may look a little more like a detention area than a natural area! As water levels recede, prairie and wetland plantings will be installed this fall.

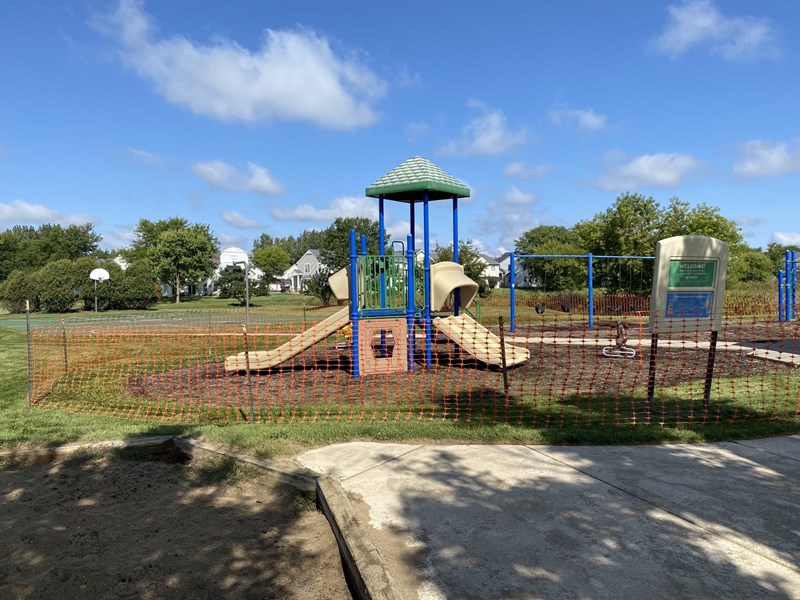

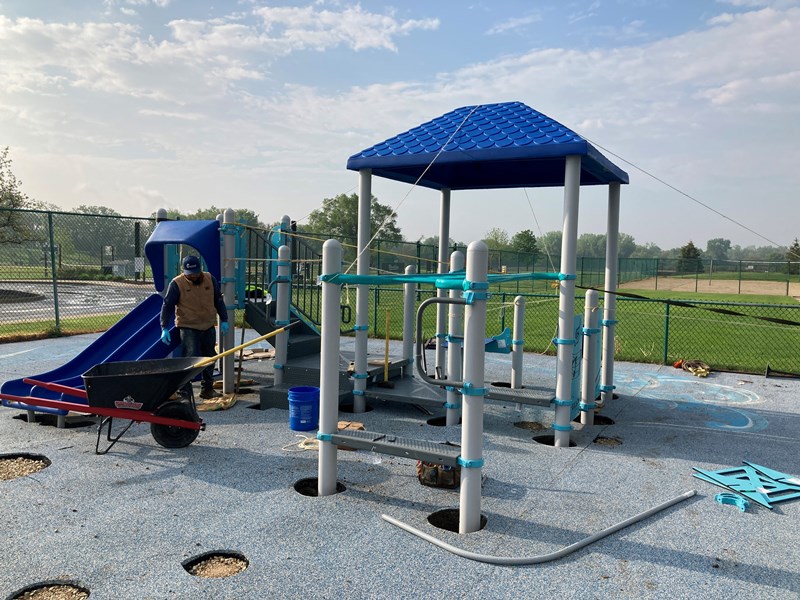

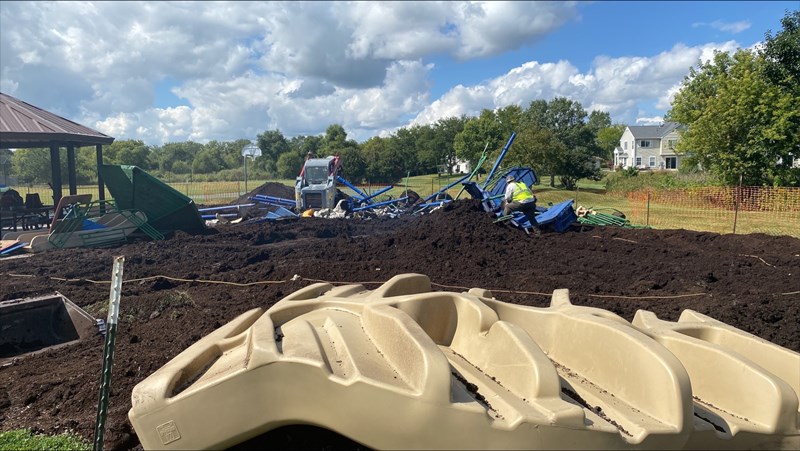

- Playground, Sand Volleyball Demo started May 1 - May 5
- Installation of new playground to start May 11
- Completion of new playground June 2 weather depending
- Site Work and Earth Moving start approx. June 2 weather depending
- Park construction through September 1 weather depending

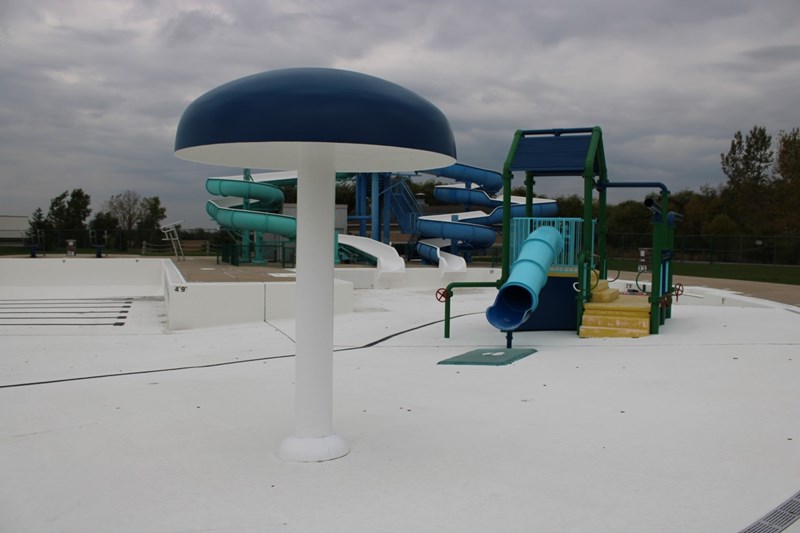

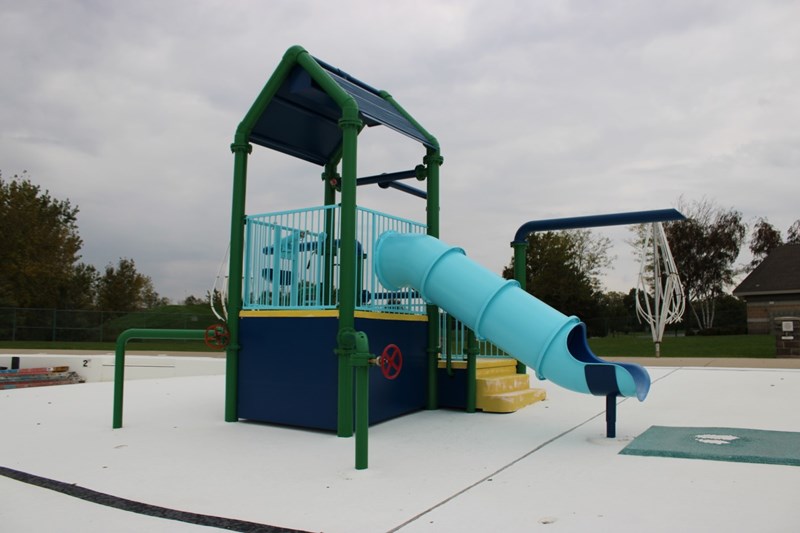

2026 - Deicke Building & Stingray Bay Roof Replacements

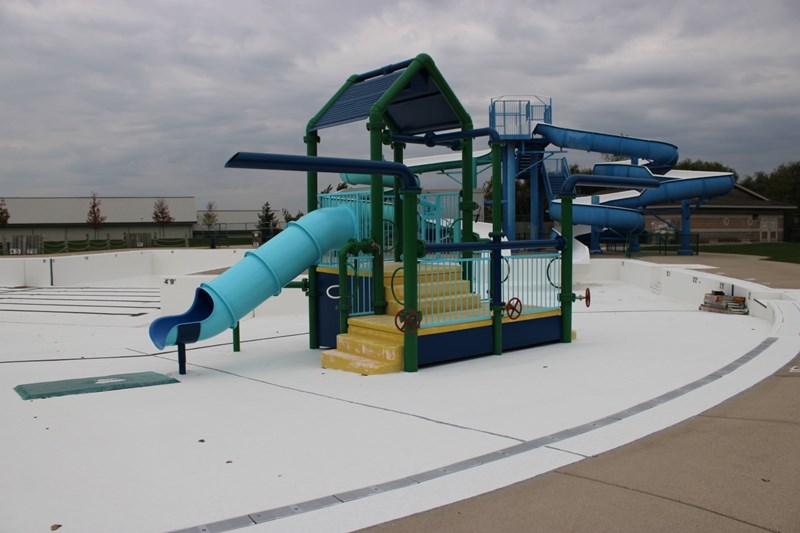

Estimated completion: Summer 2026.
Stingray Bay Family Aquatic Center set to take place in May of 2026.
Deicke Building set to take place in June, with an estimated completion date of June 15, 2026.
2026 - Pool Heater Installation
Project completed in May 2026.

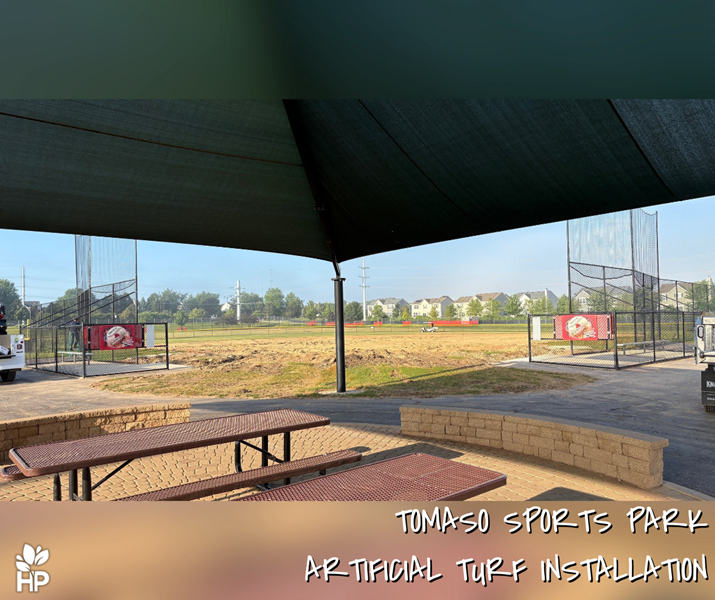

2026 - Tomaso Sports Park Turf
Project completed in January 2026.
Project outline:
-
One fully artificial turf field [infield & outfield] Field A (Amazon Field).
-
Infield turf on the following fields. Outfields will remain natural grass.
-
Field B (ARG Field)
-
Field C (TruGreen Field)
-
Field D (Niko's Field).
-
Backstop wall with padding.
-
Backstop post and netting.
-
New fencing.
-
Fields E and F will get new infield mix.
2026 - Additional Shade at Stingray Bay
Project Completed: March 2026
Added 60 tree to various park by September 2026.
2025 - Paving
In conjunction with the recently passed referendum, the Huntley Park District will be updating the paving of parking lots surrounding the Park District REC Center and Deicke Community Building in the fall of 2025. Updating these parking lots will ensure increased accessibility and improved infrastructure for waterflow and maintenance for the future.

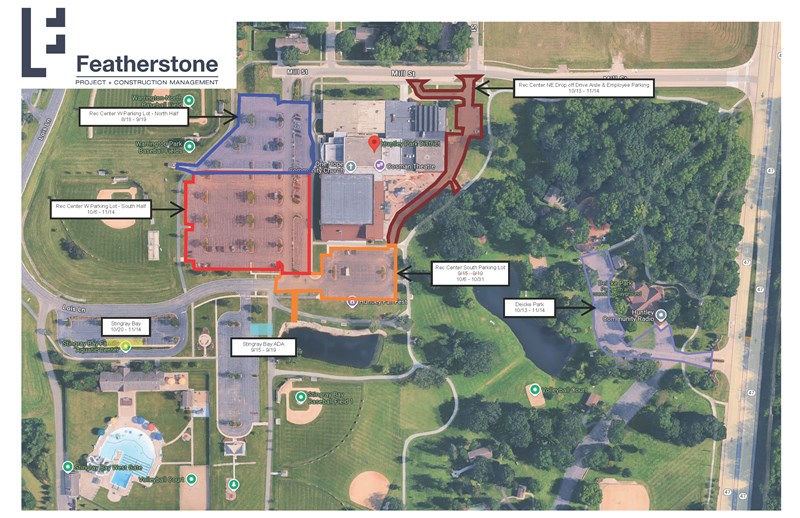

Project outline:
-
REC Center West Parking Lot - North Half (estimated dates: 8/18 - 9/19)
-
Stingray Bay Parking Lot ADA Accessibility addition (estimated dates: 9/15 - 9/19)
-
REC Center West Parking Lot - South Half (estimated dates: 10/6 - 11/14)
-
REC Center Wouth Parking Lot (estimated dates: 10/6 - 10/31)
-
Deicke Park Community Building Parking Lot (estimated dates: 10/13 - 11/14)
-
REC Center Northeast Drop Off Drive Aisle & Employee Parking Lot (estimated dates: 10/13 - 11/14)
-
Stingray Bay Handicap Parking Spots (estimated dates: 10/20 - 11/14)

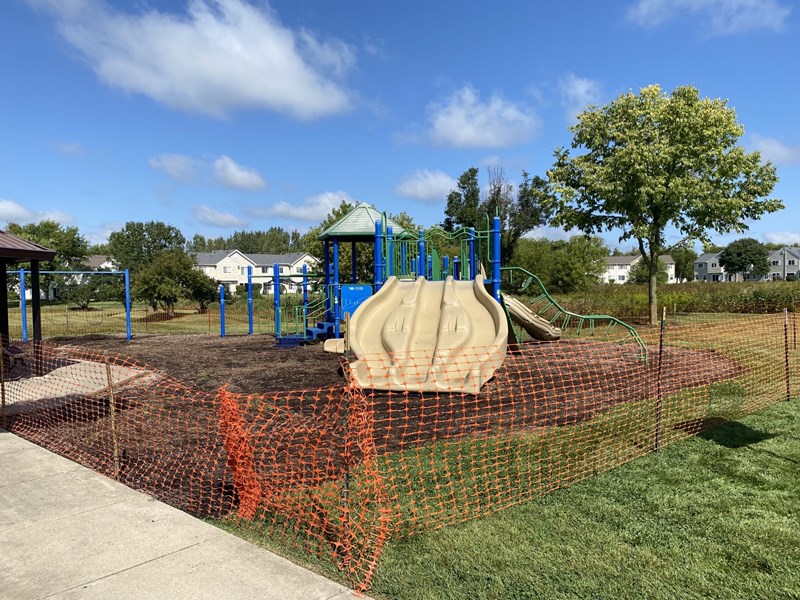

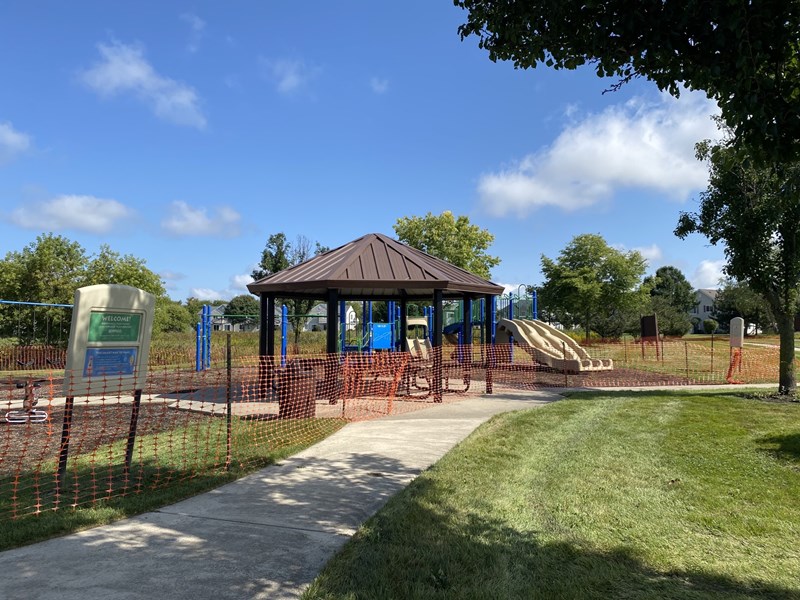

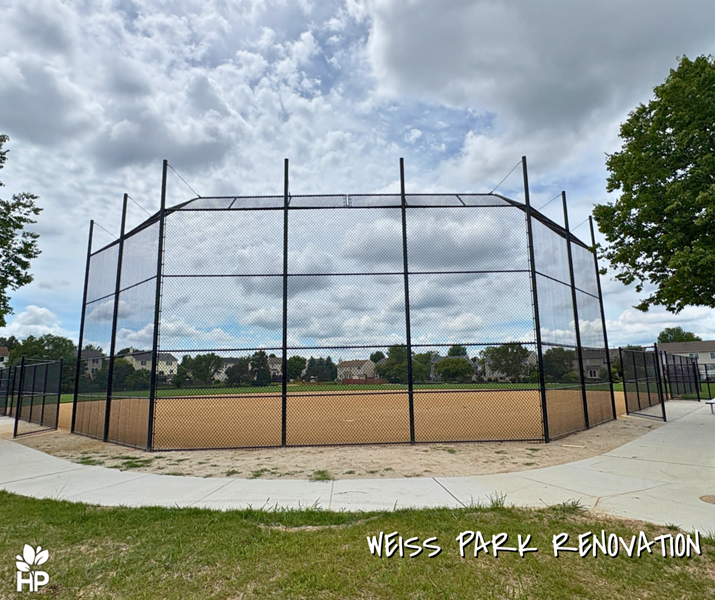

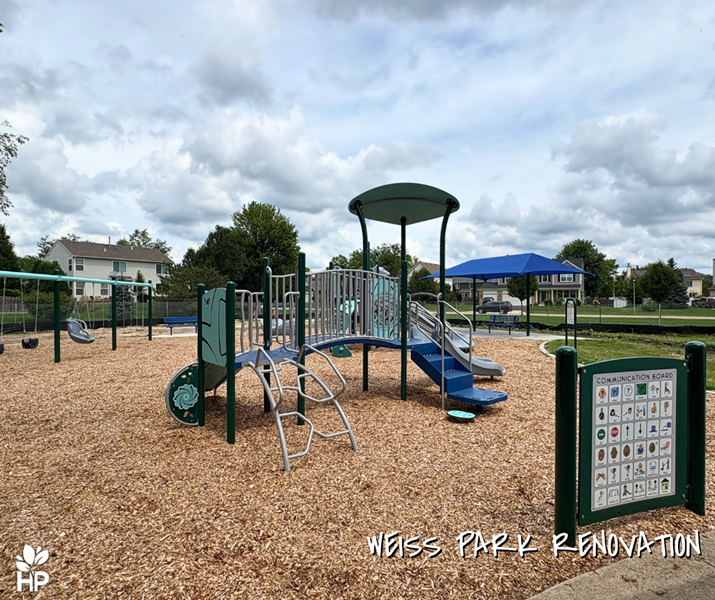

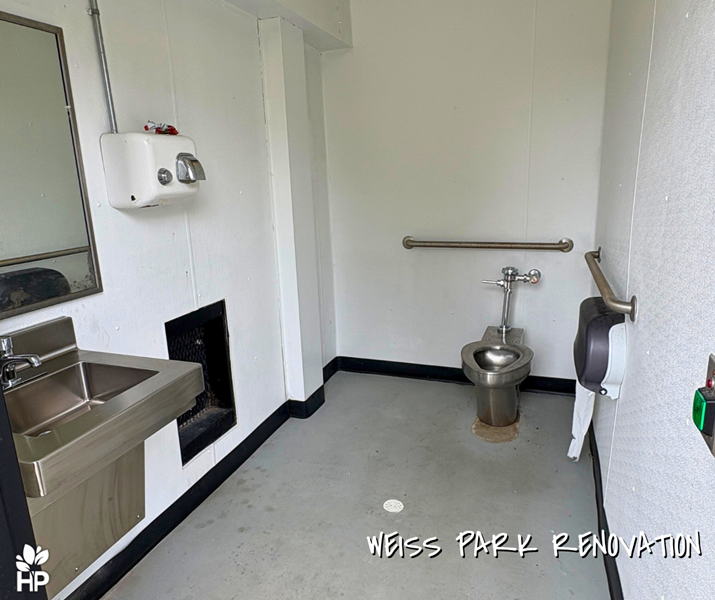

2025 - Weiss Park Playground and Park Renovations
Completed February 2026.
Weiss Park was built in 2001 and is located in the Southwind subdivision, located north of Reed Road between Haligus and Lakewood. This park is designed for children ages 2-5 and 5-12 (dependent on playground zone).
2025 - Stingray Bay Water Slide Resurfacing
2025 - Stingray Bay Shade Kits/Cantilevers
2024 - Cottontail Park Playground Renovations
Completed May 2024
Cottontail Park was built in 1998 and is located in the Southwind subdivision, located north of Reed Road between Haligus and Lakewood. This park is designed for children ages 2-12
2024 - Stingray Bay Slide Tower Repainting
2024 - Theater HVAC Unit Replacement
2024 - REC Center Masonry & Tuckpointing
2024 - Pinecrest Flooring Updates
Completed March 2024.
Pinecrest banquet area wood flooring replaced.
Banquet area carpeting replaced.
Pro Shop flooring to be updated.
2024 - REC Center Security Updates
Completed February 2024.
REC Center security system updated.
